Project Summary

The City of Plattsburgh is advancing the Saranac River Trail Phase III Project (PIN 7806.61), the third and final phase of the City’s planned waterfront trail system along the Saranac River.

Phase III will complete a continuous multi-use trail connection between the existing Plattsburgh Riverwalk, Bridge Street, Green Street, and Peace Point Park. This project will provide improved bicycle and pedestrian access to the Saranac River and Lake Champlain waterfront, while enhancing safety and mobility along key downtown corridors.

The project is being administered by the City of Plattsburgh with oversight support from NYSDOT Region 7 and coordination with the Federal Highway Administration (FHWA). Funding has been awarded through the Transportation Alternatives Program (TAP).

Project Goals and Improvements

The Saranac River Trail Phase III Project will enhance recreation, transportation connectivity, and waterfront access through improvements including:

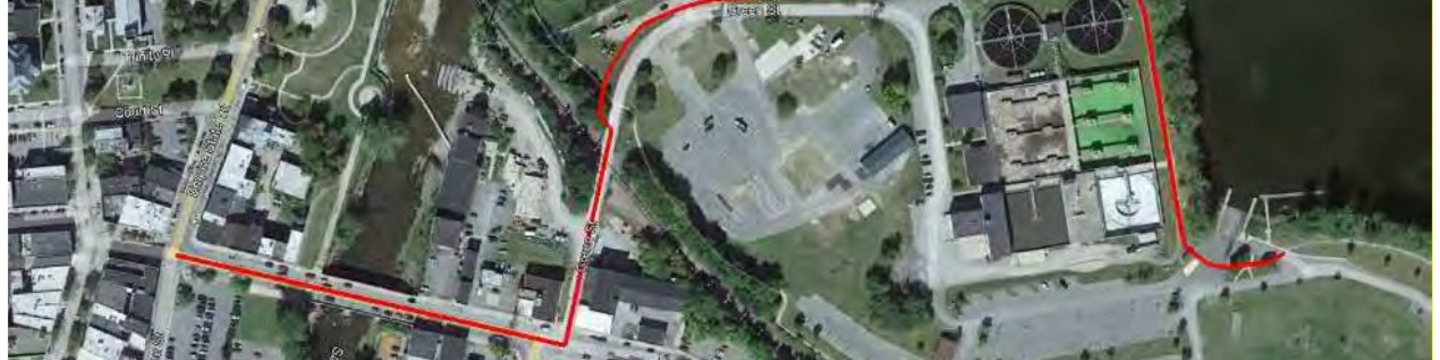

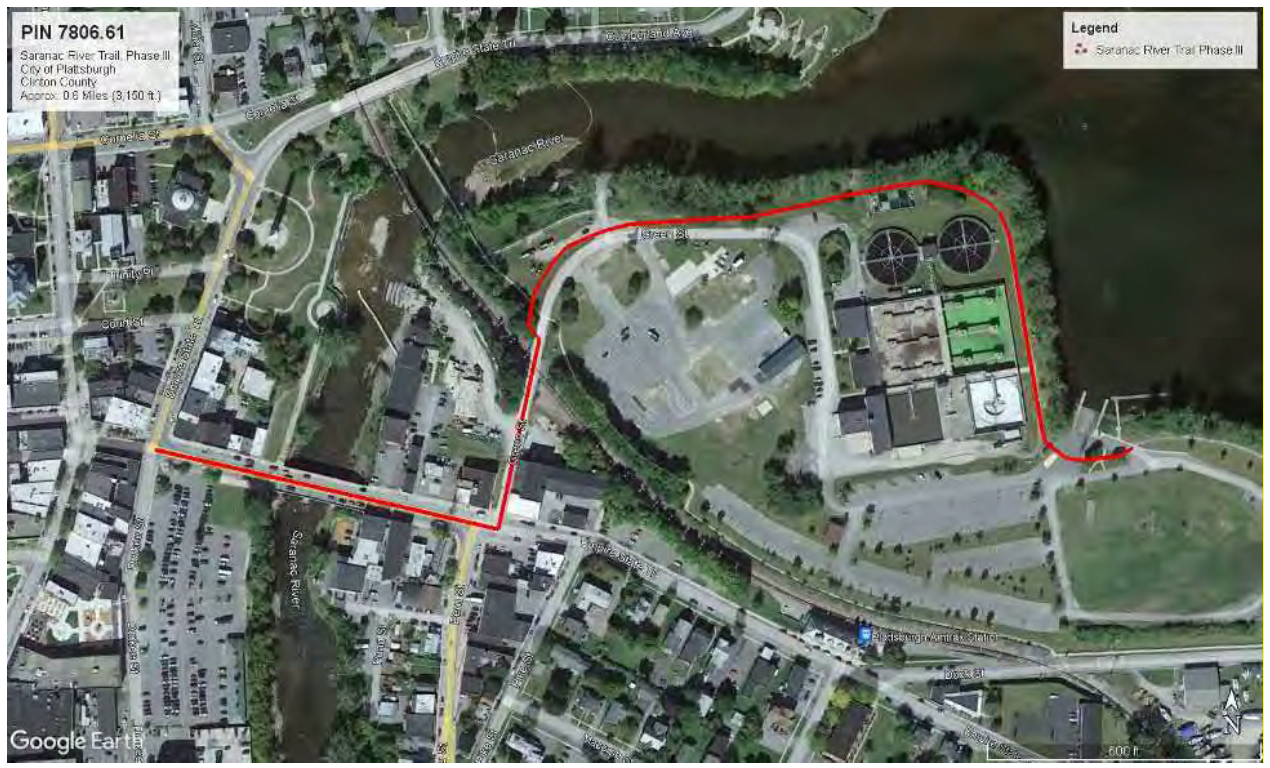

  • Construction of an approximately 0.6-mile trail connection consisting of both on-road and off-road facilities
  • Installation of two designated bicycle lanes along Bridge Street
  • Addition of high-visibility pedestrian and bicycle crossings and ADA-compliant curb bump-outs at key locations
  • Shared roadway signage and pavement markings along Green Street to support bicyclists and pedestrians
  • Construction of a new 10-foot-wide asphalt shared-use path connecting Green Street to Peace Point Park
  • Realignment and grading improvements to the Plattsburgh Heritage Trail and improved trail crossings
  • Enhanced waterfront access and recreational opportunities for residents and visitors
You're viewing real-time data. Participant counts are continuously updated for administrators. Please note that regular users see cached data, which may result in slight differences in the numbers.

Phases

Phases overview
Phase 1: Design & Coordination Phase
Design & Coordination Phase

Design & Coordination Phase

April 1, 2024 4:00 AM - No end date

The project is currently in the design and coordination phase. A Public Information Meeting was held in February 2024 to share proposed improvements and gather feedback from residents, stakeholders, and local businesses.

Design approval and right-of-way phase approved are in April 2024, with final design activities continuing into 2025 and the beginning of 2026.

Upcoming milestones for the Saranac River Trail Phase III Project include:

  • Advance Detail Plans Completion: February 2026
  • Authorization to Advertise: March 2026
  • Bidding: March 2026
  • Construction Start: May 2026
  • Construction Completion: November 2026
